Project

General

Profile

Gantt

Filters

Zoom in Zoom out

months from Apply Clear

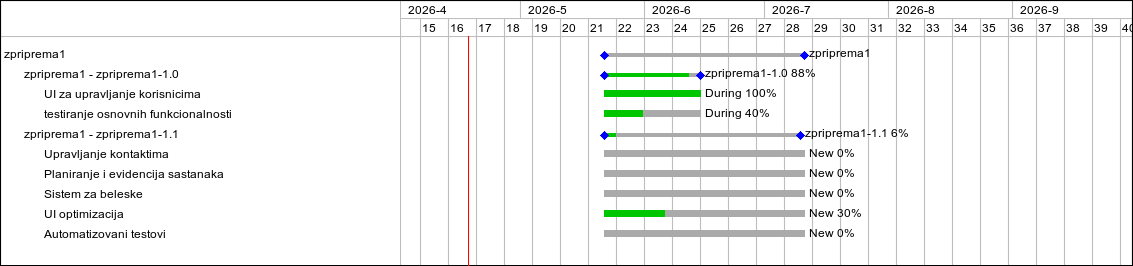

Issue #4531: UI za upravljanje korisnicima
Issue #4532: testiranje osnovnih funkcionalnosti
Issue #4533: Upravljanje kontaktima
Issue #4534: Planiranje i evidencija sastanaka
Issue #4535: Sistem za beleske
Issue #4536: UI optimizacija
Issue #4537: Automatizovani testovi


15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39



zpriprema1




zpriprema1-1.0 88%


During 100%
Issue #4531: UI za upravljanje korisnicima

Project: zpriprema1
Status: During
Start date: 05/22/2026
Due date: 06/14/2026
Assignee:
Priority: Normal


During 40%
Issue #4532: testiranje osnovnih funkcionalnosti

Project: zpriprema1
Status: During
Start date: 05/22/2026
Due date: 06/14/2026
Assignee:
Priority: Normal




zpriprema1-1.1 6%

New 0%
Issue #4533: Upravljanje kontaktima

Project: zpriprema1
Status: New
Start date: 05/22/2026
Due date: 07/10/2026
Assignee:
Priority: Normal

New 0%
Issue #4534: Planiranje i evidencija sastanaka

Project: zpriprema1
Status: New
Start date: 05/22/2026
Due date: 07/10/2026
Assignee:
Priority: Normal

New 0%
Issue #4535: Sistem za beleske

Project: zpriprema1
Status: New
Start date: 05/22/2026
Due date: 07/10/2026
Assignee:
Priority: Normal


New 30%
Issue #4536: UI optimizacija

Project: zpriprema1
Status: New
Start date: 05/22/2026
Due date: 07/10/2026
Assignee:
Priority: Normal

New 0%
Issue #4537: Automatizovani testovi

Project: zpriprema1
Status: New
Start date: 05/22/2026
Due date: 07/10/2026
Assignee:
Priority: Normal


Also available in: PDF PNG
