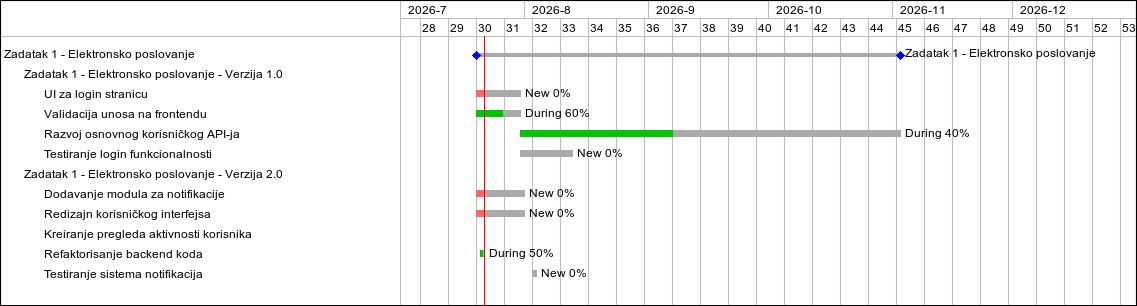

Project

General

Profile

Gantt

Filters

Zoom in Zoom out

months from Apply Clear

Issue #4941: UI za login stranicu
Issue #4943: Validacija unosa na frontendu
Issue #4940: Razvoj osnovnog korisničkog API-ja
Issue #4942: Testiranje login funkcionalnosti
Issue #4944: Dodavanje modula za notifikacije
Issue #4945: Redizajn korisničkog interfejsa
Issue #4946: Kreiranje pregleda aktivnosti korisnika
Issue #4948: Refaktorisanje backend koda
Issue #4947: Testiranje sistema notifikacija


28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
45
46
47
48
49
50
51
52



Zadatak 1 - Elektronsko poslovanje


New 0%
Issue #4941: UI za login stranicu

Project: Zadatak 1 - Elektronsko poslovanje
Status: New
Start date: 07/20/2026
Due date: 07/30/2026
Assignee: Aleksa Barac
Priority: Normal


During 60%
Issue #4943: Validacija unosa na frontendu

Project: Zadatak 1 - Elektronsko poslovanje
Status: During
Start date: 07/20/2026
Due date: 07/30/2026
Assignee: Aleksa Barac
Priority: High


During 40%
Issue #4940: Razvoj osnovnog korisničkog API-ja

Project: Zadatak 1 - Elektronsko poslovanje
Status: During
Start date: 07/31/2026
Due date: 11/02/2026
Assignee: Vuk Petrovic
Priority: High

New 0%
Issue #4942: Testiranje login funkcionalnosti

Project: Zadatak 1 - Elektronsko poslovanje
Status: New
Start date: 07/31/2026
Due date: 08/12/2026
Assignee: Ana Savic
Priority: Normal


New 0%
Issue #4944: Dodavanje modula za notifikacije

Project: Zadatak 1 - Elektronsko poslovanje
Status: New
Start date: 07/20/2026
Due date: 07/31/2026
Assignee: Vuk Petrovic
Priority: Normal


New 0%
Issue #4945: Redizajn korisničkog interfejsa

Project: Zadatak 1 - Elektronsko poslovanje
Status: New
Start date: 07/20/2026
Due date: 07/31/2026
Assignee: Aleksa Barac
Priority: Normal


During 50%
Issue #4948: Refaktorisanje backend koda

Project: Zadatak 1 - Elektronsko poslovanje
Status: During
Start date: 07/21/2026
Due date: 07/21/2026
Assignee: Vuk Petrovic
Priority: Normal

New 0%
Issue #4947: Testiranje sistema notifikacija

Project: Zadatak 1 - Elektronsko poslovanje
Status: New
Start date: 08/03/2026
Due date: 08/03/2026
Assignee: Ana Savic
Priority: Normal
